December 2025 Construction Updates
Recent Activities:

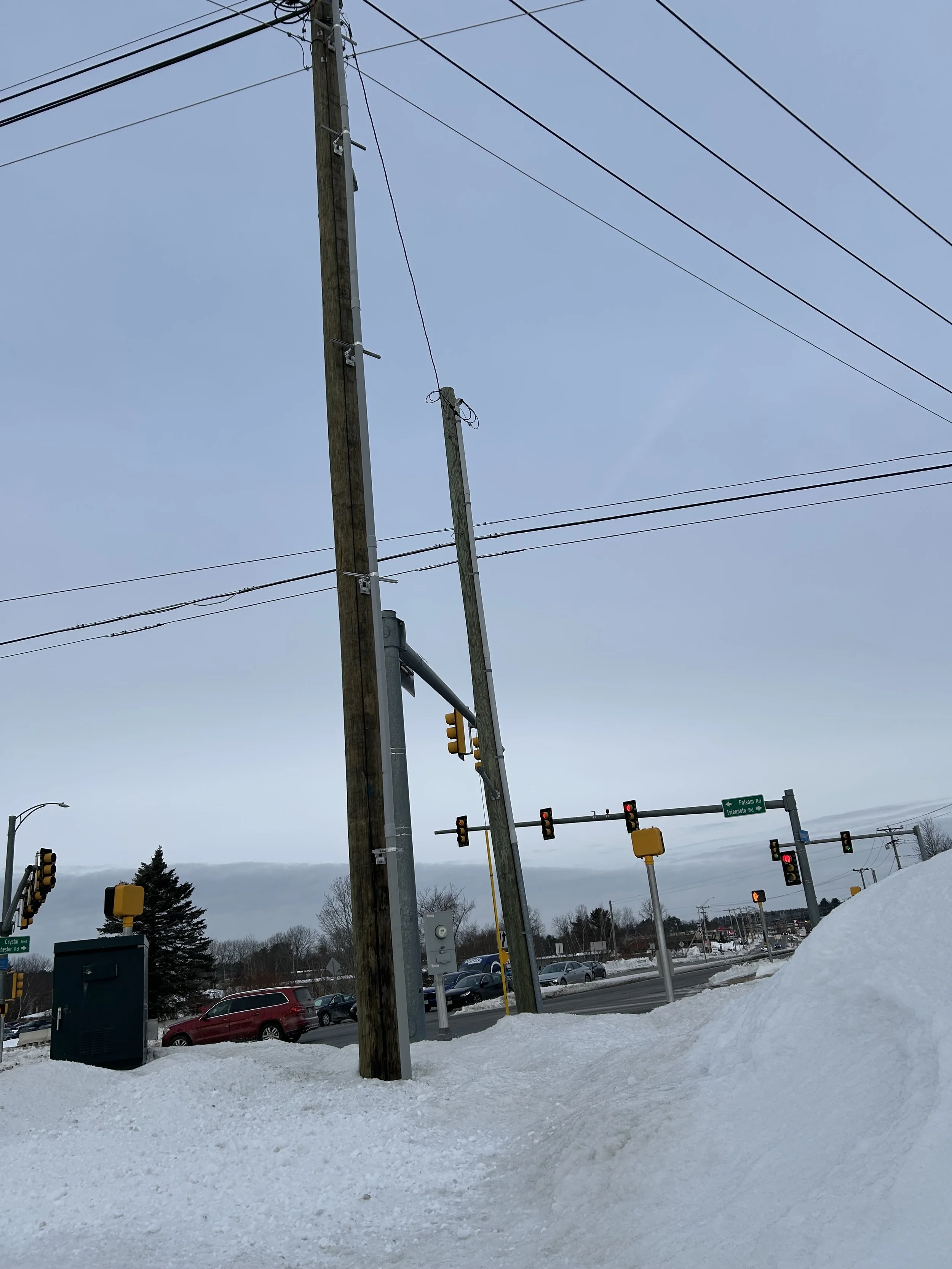

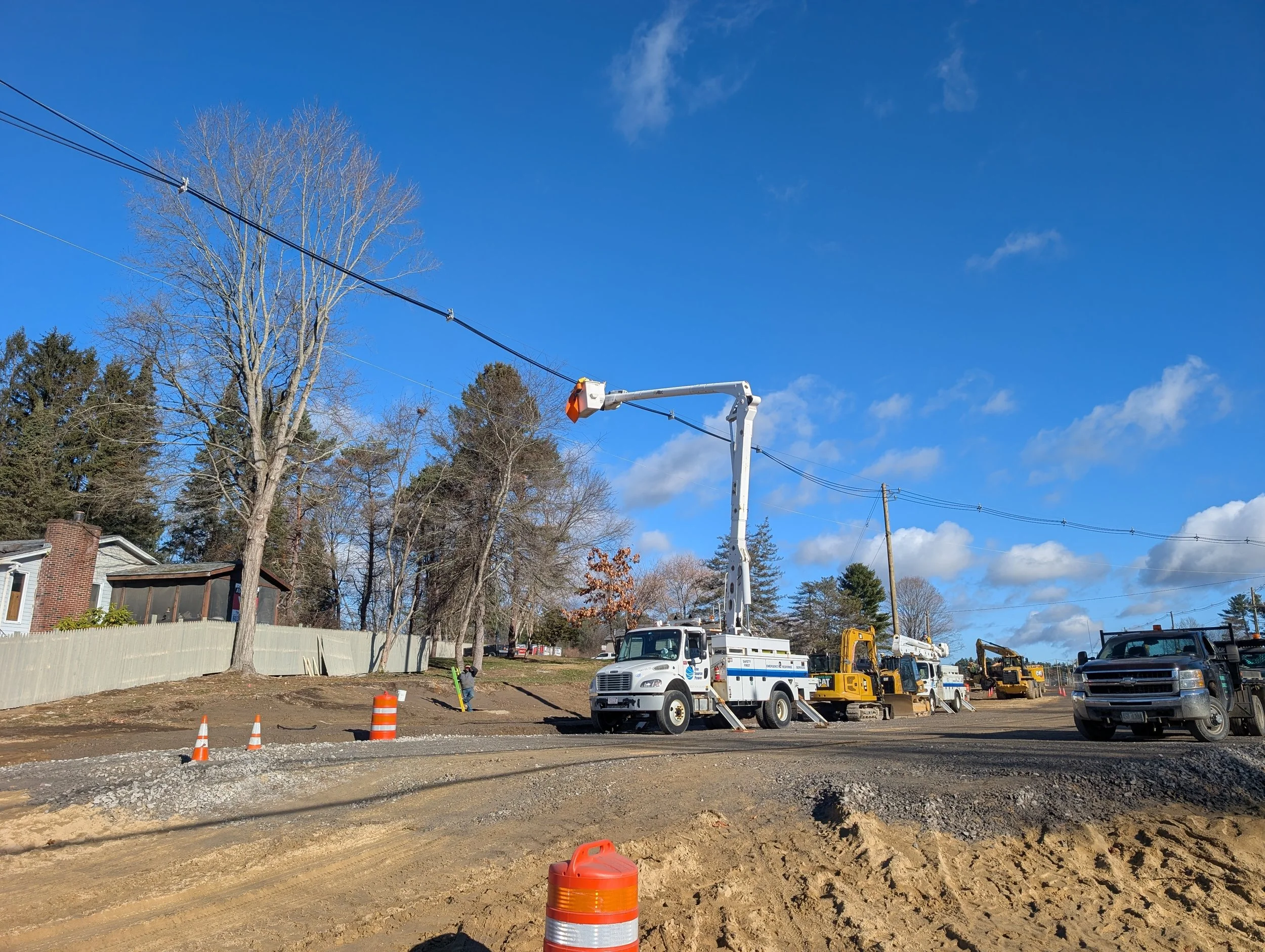

Overhead power relocation efforts have continued with wires being pulled into place. Electrical line installation will continue until it is completed.
The sewer extension along the north side of Folsom Road is under construction.

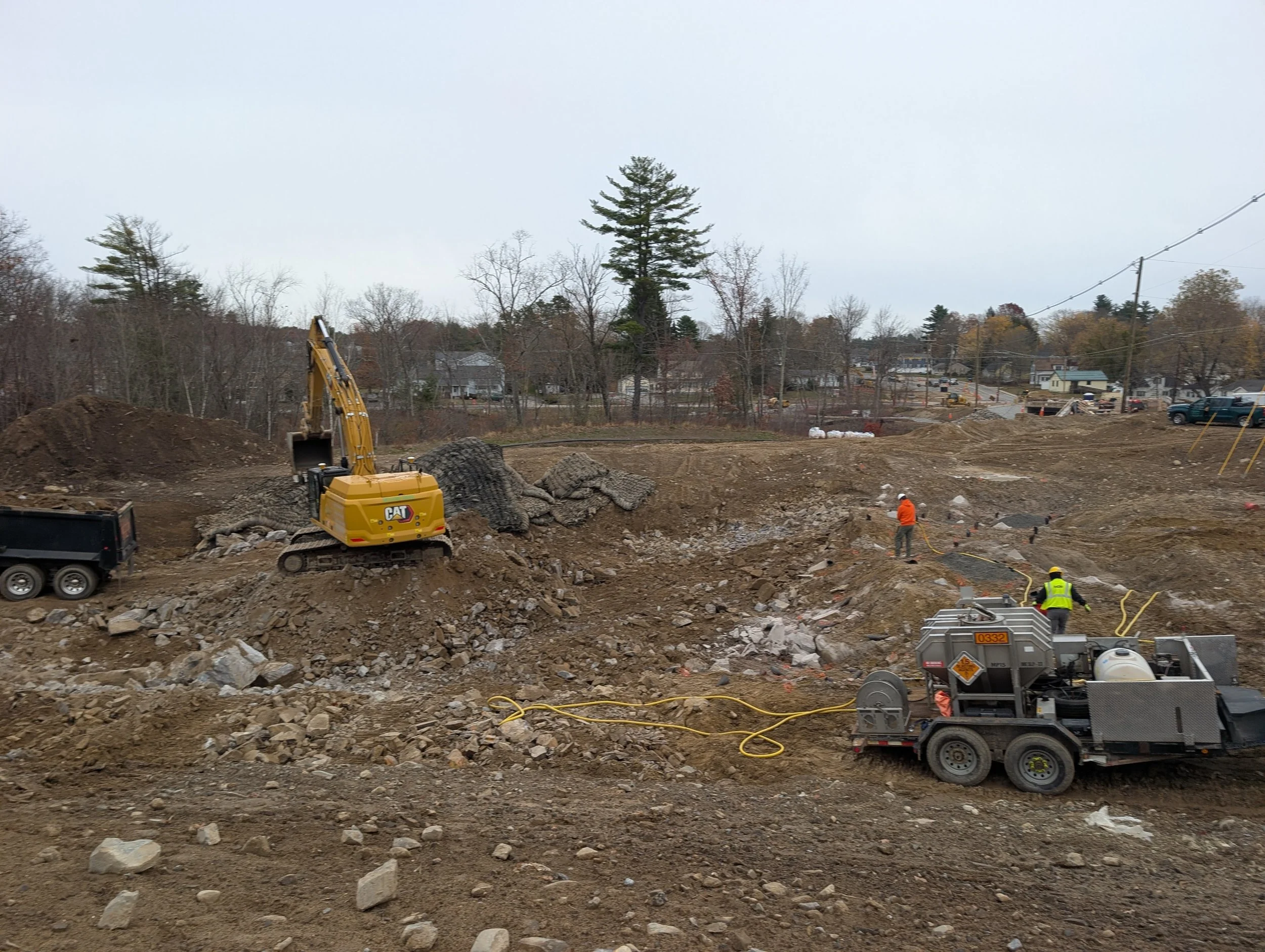

Excavation of the Shields Brook Stormwater Treatment Site, including required blasting, is complete.

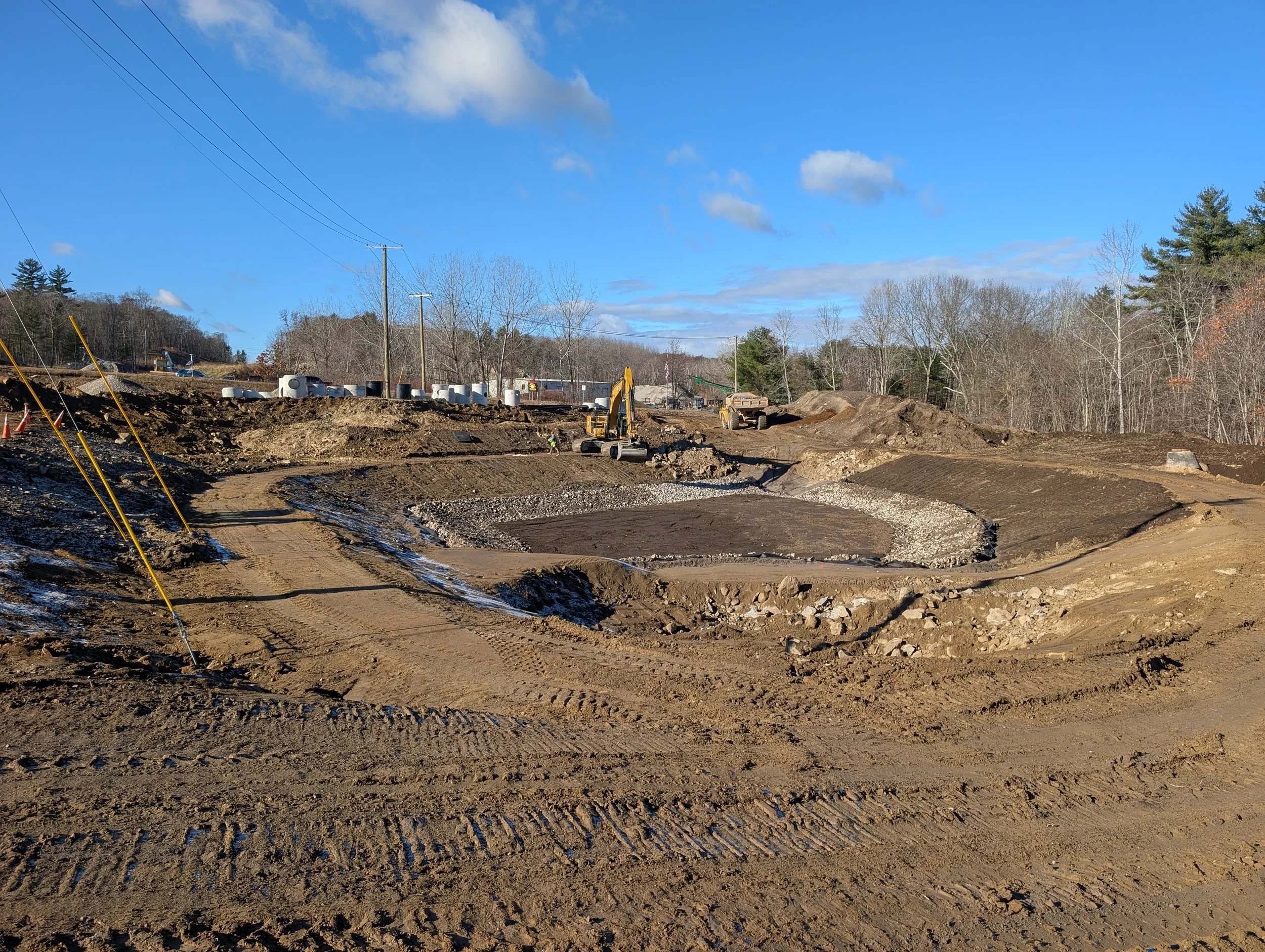

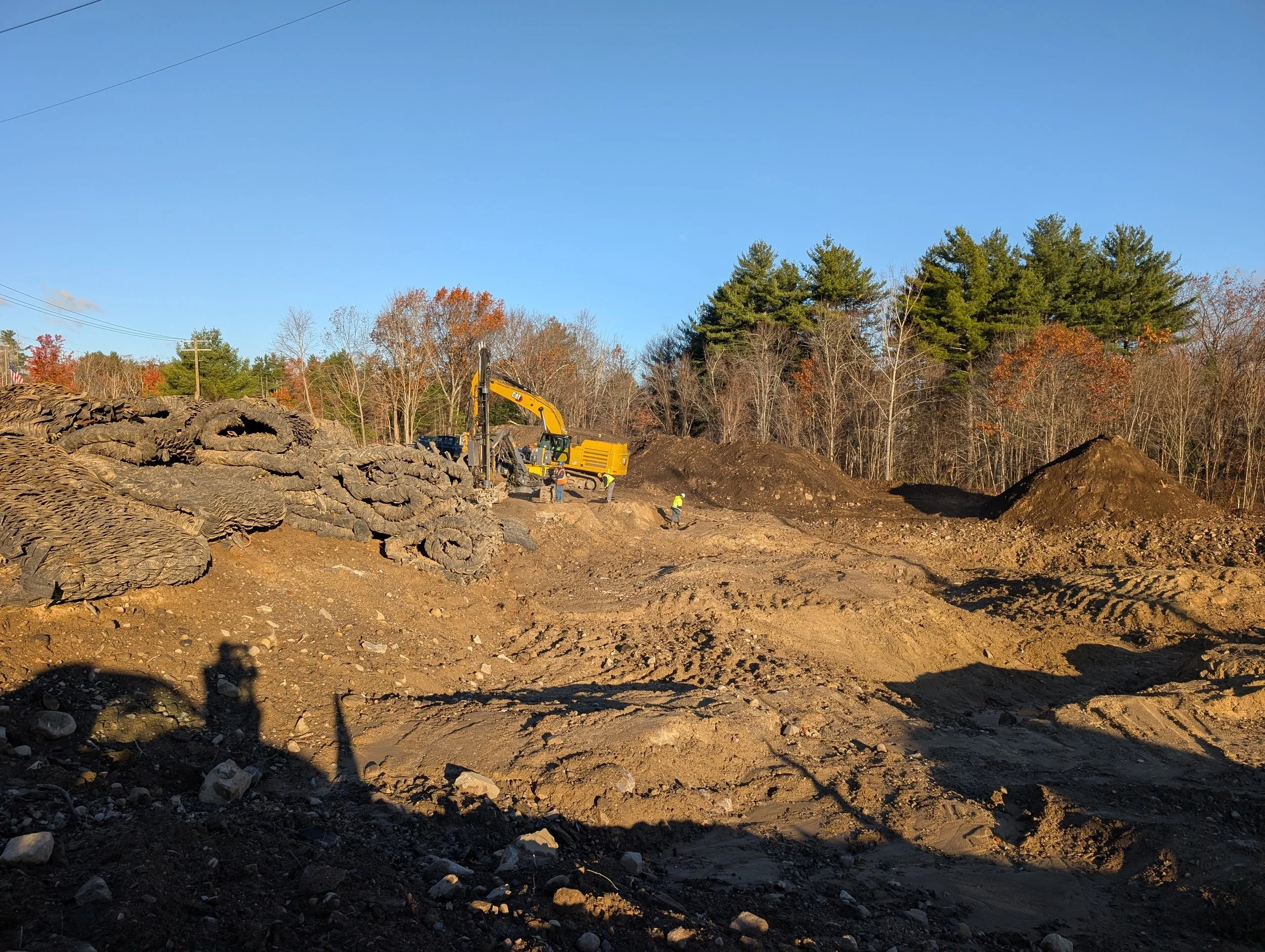

Installation of humus and stone has begun in the Shields Brook Stormwater Treatment Site.

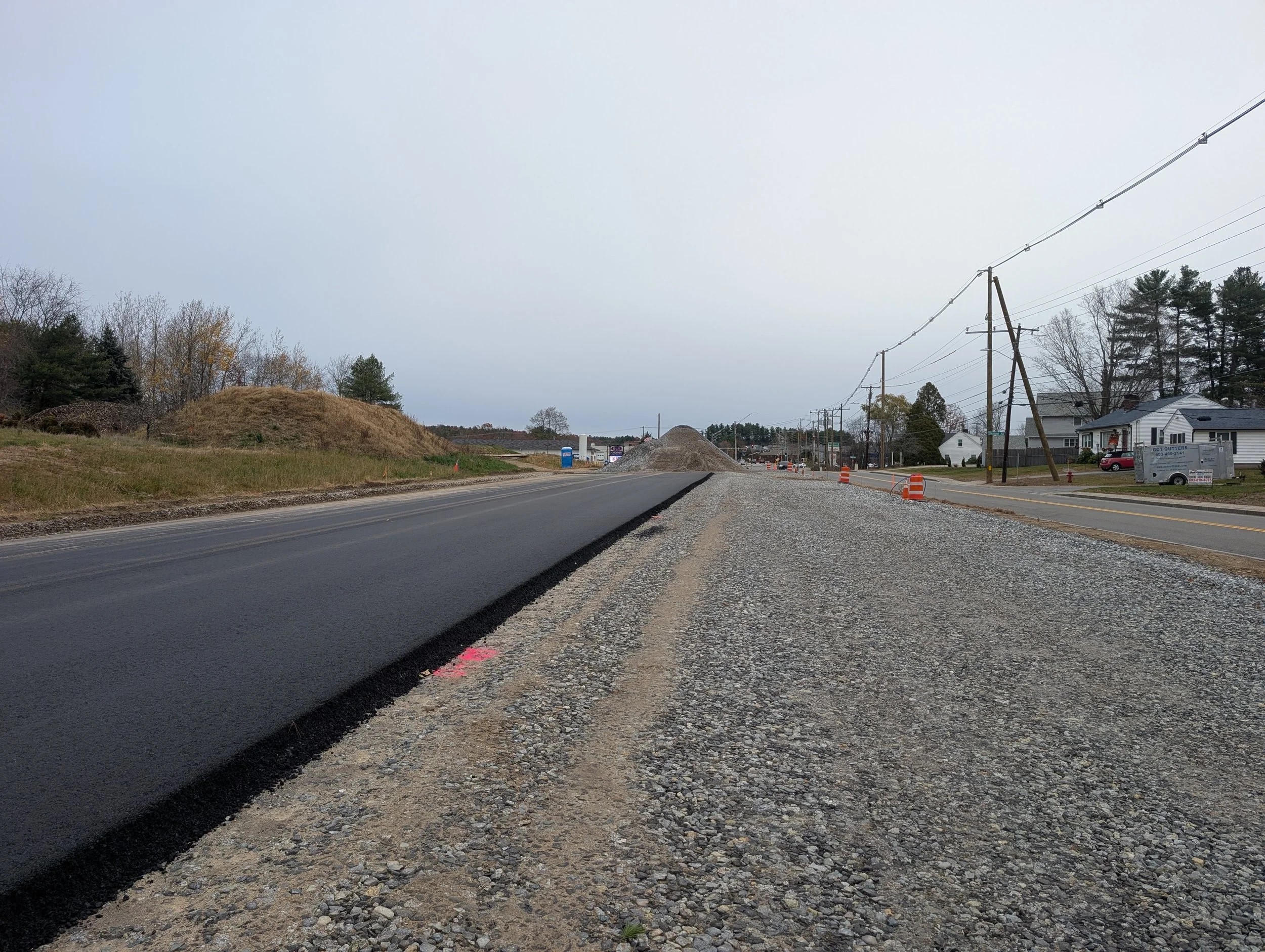

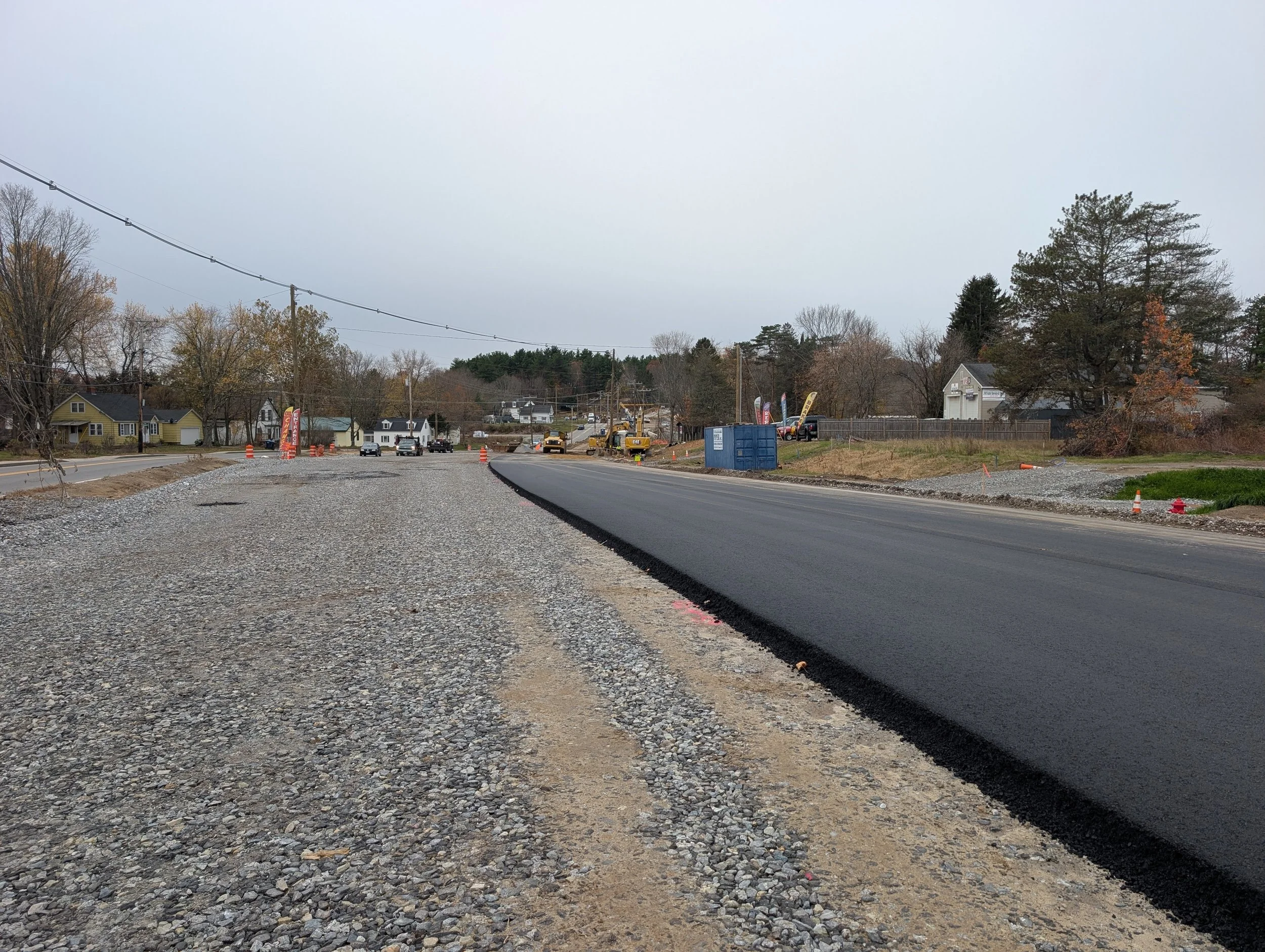

Madden Road was paved along with completed parts of Folsom Road between Franklin Street and Laconia Avenue.
Deck forms have been removed from the underside of the bridge.
Upcoming Activities:
Power work at American Excavating is anticipated to be completed in the first 2 weeks of December.
Full power relocation efforts are expected to be complete by the end of December.
Temporary paving of Franklin Street Extension will take place as soon as possible in December.
The installation of sewer will continue along the North side of Folsom.
Sewer work on Folsom Road will start at the Franklin Street intersection and move east towards Rt 28.
November 2025 Construction Updates
Recent Activities:
Overhead power relocation efforts have continued with wires being pulled into place, and will continue until complete.

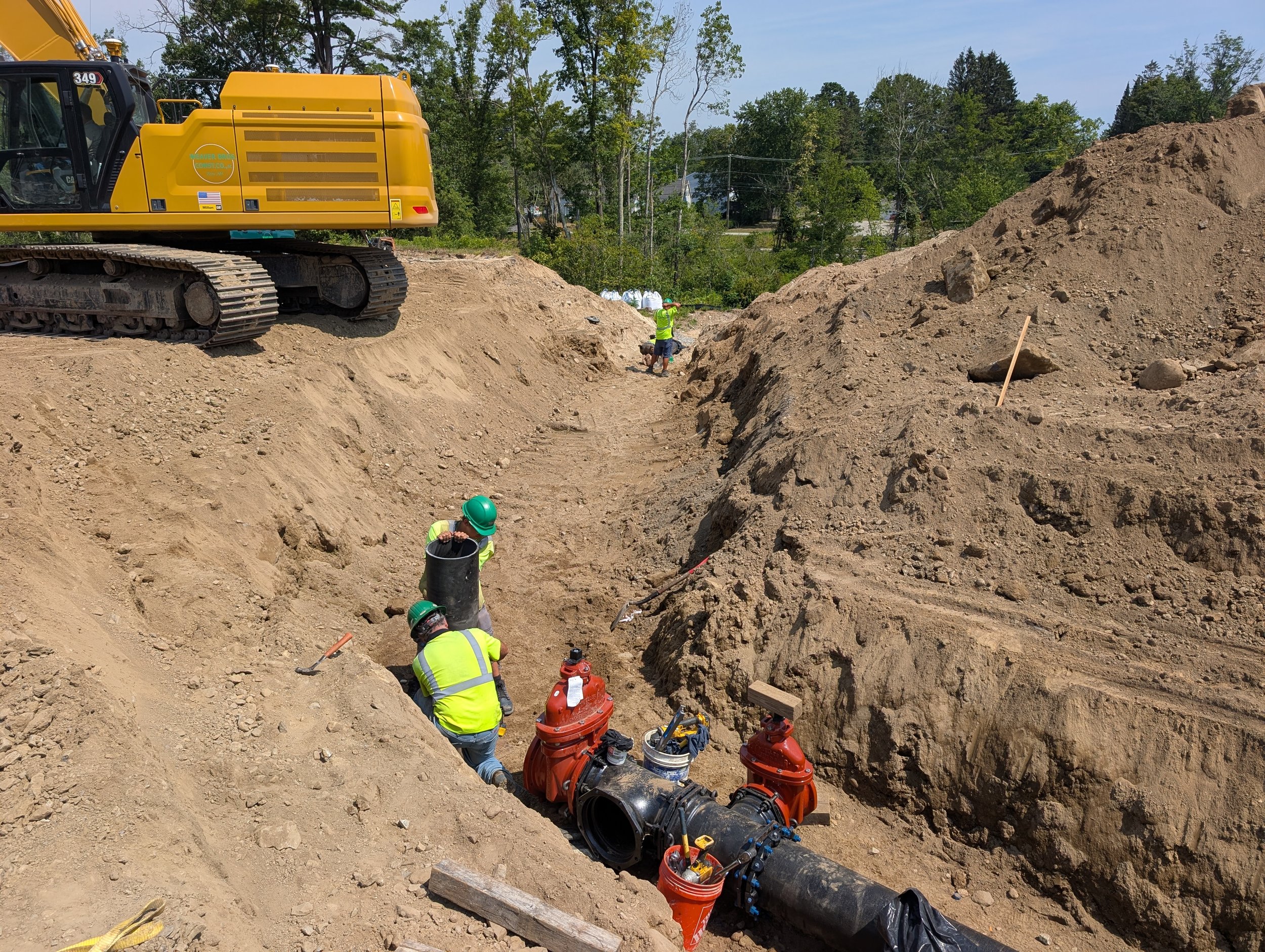

Waterlines throughout Phase 1 are being installed and pressure tested.
Gas line relocation on Folsom Road is complete.
The cap for the Northwest MSE Wingwall has been installed.
Form work for the Shields Brook Bridge deck was completed, shear connectors were installed, and deck reinforcing was installed and approved.
The deck placement for Phase 1 occurred on the 28th of October.
Sewer work at Franklin Extension intersection has begun.
Upcoming Activities:
The closure placement, sidewalk and median curb are anticipated early November.
Power relocation efforts are anticipated to be complete by the end of the month.
Paving of Madden Road and completed parts of Folsom Road will take place in early November.
The installation of sewer and waterline will continue in areas permitted by the New Hampshire Department of Transportation (NH DOT).
Water main installation on North High Street will continue.
Sewer work on Folsom will start at the Franklin intersection and move east towards Route 28.
October 2025 Construction Updates
Recent Activities:
Steel girders for Phase 1 were set in the last two weeks of September.
Overhead power relocation efforts have continued with new poles installed throughout the jobsite. Electrical line installation has begun and will continue until completed.
Waterlines throughout Phase 1 are installed and being pressure tested.
Gas line relocation on Folsom Road is ongoing.
The MSE Wingwall for the Northwest corner of the bridge has been installed.
Bolt tensioning has been completed
Both abutments were backfilled to the height of the bridge seats.
Forming for the deck concrete has commenced and will continue until complete.
Upcoming Activities:
Work on form installation for the bridge deck will continue until complete.
Deck studs will be installed next week.
Rebar installation will commence once forming and studs are complete.
The installation of sewer and waterline will continue in areas permitted by the New Hampshire Department of Transportation (NH DOT).
Water main installation on North High Street will continue.
Paving of Madden Road and Folsom for Phase 1 between the bridge and carwash is anticipated during the month of October.
